Road Crash Case Information System (CrashForm)
To protect privacy and security, this project has been modified and sensitive information is not displayed.
Role: Business Analyst & Project Manager
Overview: Led the business analysis and project management for the digital transformation of road crash data collection for the Ministry of Internal Affairs Patrol Police Department. The project replaced paper-based crash reporting with a GPS-enabled tablet application, creating a structured and more efficient process for collecting, validating and analyzing road accident data.
End-to-end analysis and delivery artifacts
Gap Analysis

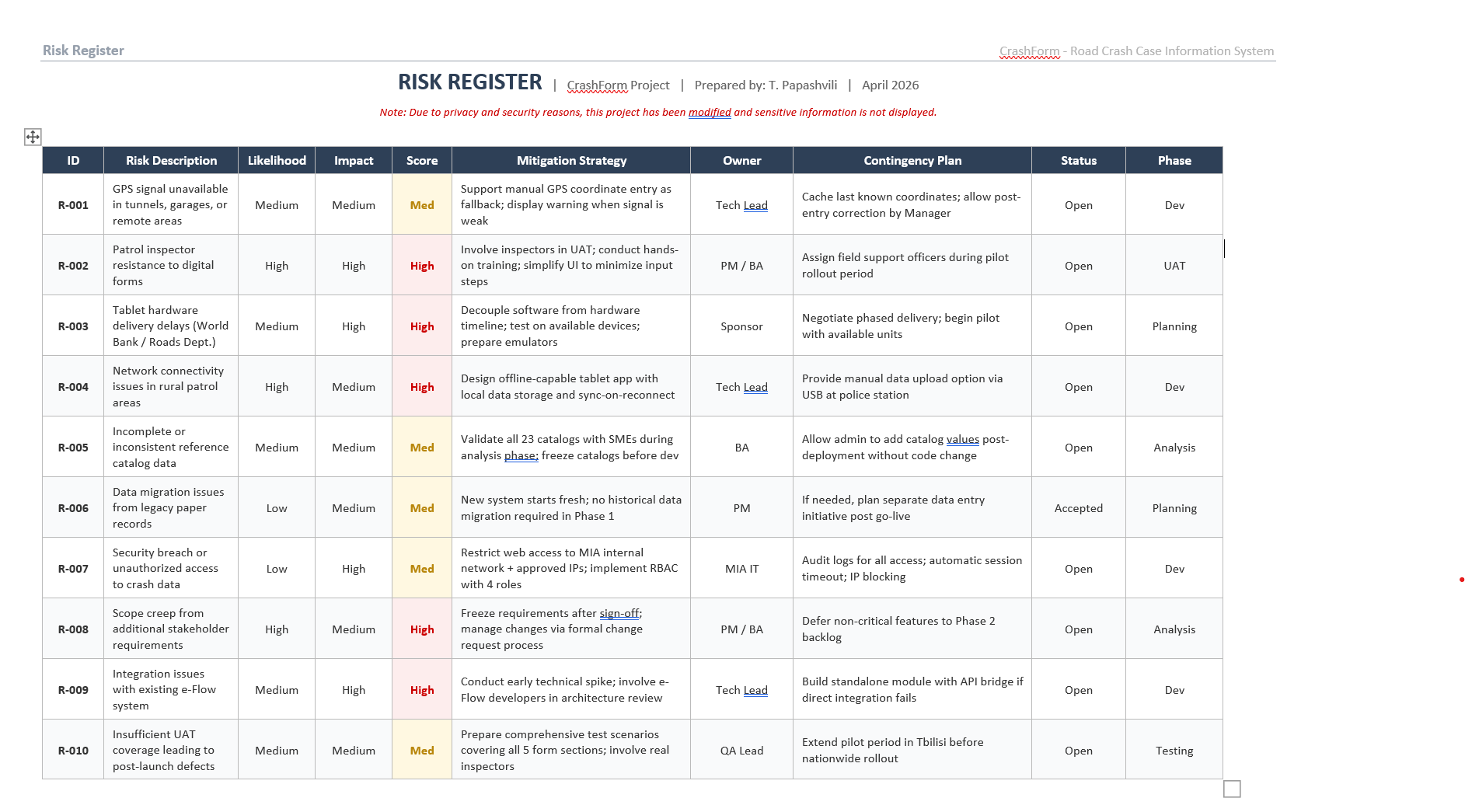

Analyzed the current process, gaps, challenges and opportunities for digitalization.
DownloadFunctional Requirements
Documented functional and non-functional requirements, business rules, system behavior and reference data.
DownloadUse Cases & User Stories
Translated business needs into scenarios, user stories and expected system behavior.
DownloadStakeholder Analysis
Mapped internal and external stakeholders using a mind map and Onion Diagram.
DownloadProject Charter
Defined purpose, objectives, scope, stakeholders, deliverables, assumptions, constraints and governance.

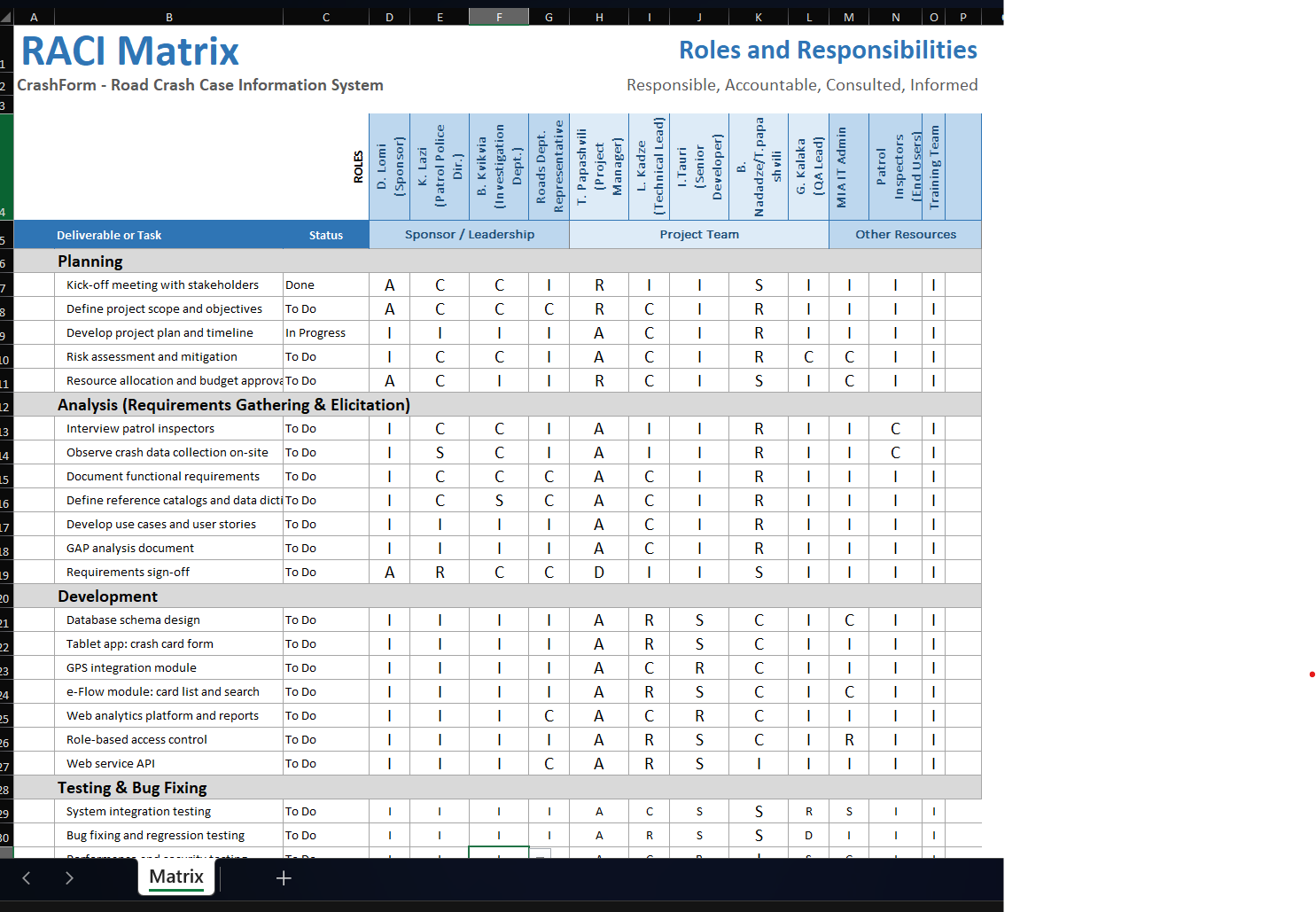

DownloadRACI Matrix
Clarified who was Responsible, Accountable, Consulted and Informed across delivery.
DownloadCommunication Plan
Defined methods, frequency, audiences, responsibilities and objectives for engagement and reporting.

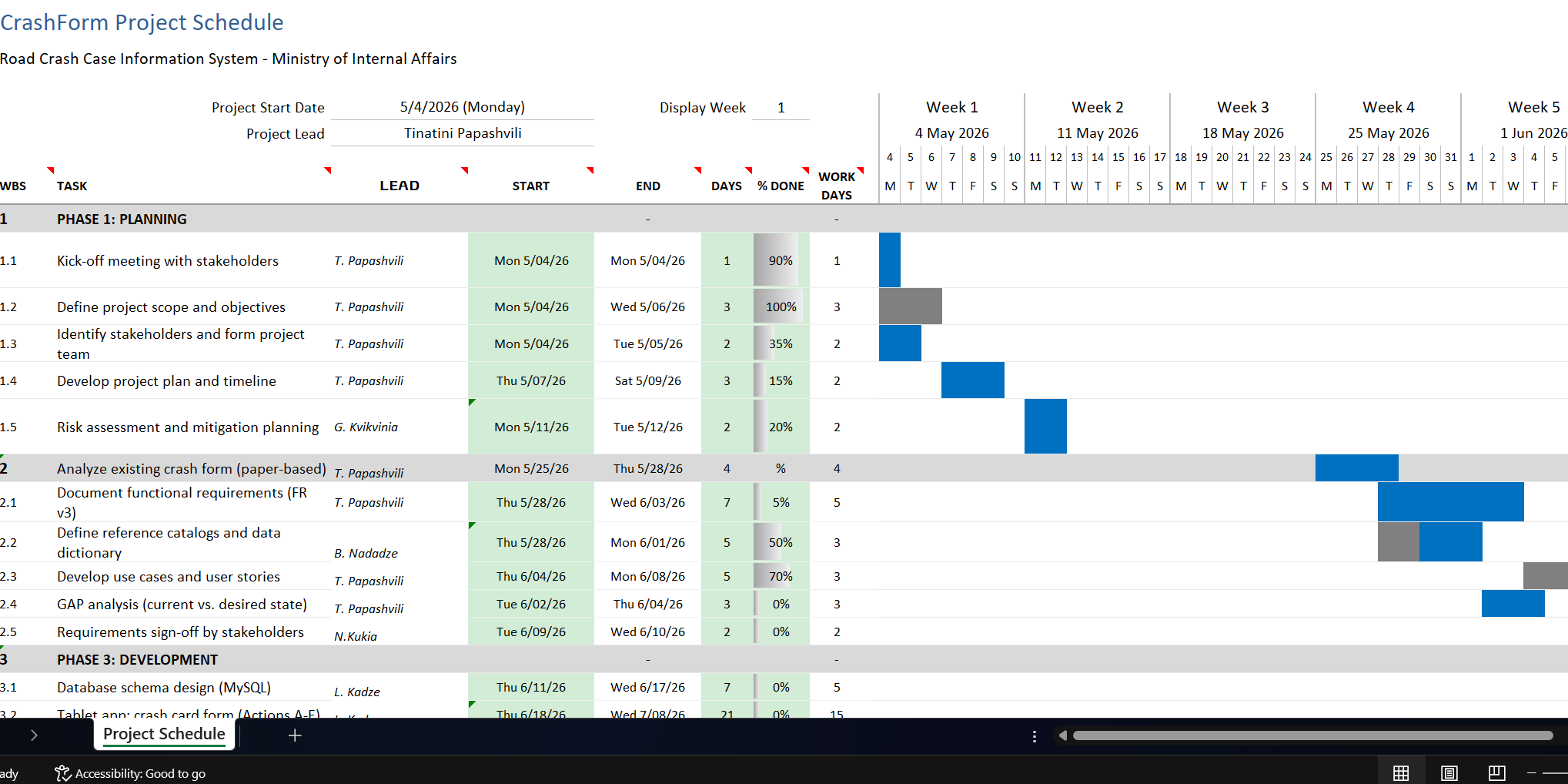

DownloadGantt Chart & Schedule
Planned activities, milestones, dependencies, timelines and delivery phases.
DownloadAnalytics & Integration
Defined reporting, data and API integration requirements for road safety analysis and decision-making.
Related artifactRequirements Traceability
Maintained alignment between needs, requirements, use cases, system functionality and validation.
Request detailsSystem User Manuals
Prepared practical guidance covering system functionality, workflows and day-to-day operations.
Request details
